MetroBus Extension Build

Photomontage of the proposed replacement railway bridge on Gipsy Patch Lane, looking westwards

This page brings together news and resources relating to the construction of the Cribbs Patchway MetroBus Extension (CPME) route through Little Stoke and Stoke Gifford. For background information on how the CPME scheme has evolved, including the controversy over a proposed bus lane on Hatchet Road, visit the Journal’s main CPME page.

Early preparatory work began on Gipsy Patch Lane on Monday 25th February 2019 to divert underground utilities and undertake surveys in preparation for the main construction work.

Traffic management has been used in the vicinity of the railway bridge from 2nd September 2019 as further preparations are made.

An estimated 8-month closure of Gipsy Patch Lane at the railway bridge began on Thursday 5th March 2020.

Further road and lane closures, stretching well into 2021, will be required for highway works either side of the bridge.

Quick overview: What happens next?

NEW: The bridge move on Gipsy Patch Lane will now take place between Saturday 24th October and the early hours of Saturday 7th November 2020.

The bridge move had originally been scheduled to take place between Saturday 11th April and Sunday 19th April 2020, but was postponed due to the coronavirus emergency.

Recent updates

UPDATE (12th June 2020): The footpath under the Gipsy Patch Lane railway bridge is now open 24/7 again. It had been closed during weekday working hours (8am-4pm) since 20th May 2020.

UPDATE (4th June 2020): To enable Network Rail and Alun Griffiths to continue preparatory and highways work the footpath under the bridge is planned to remain closed between 8am and 4pm Monday to Friday, up to and including Friday 12th June. Until this date the footpath under the railway bridge will only open to pedestrians and dismounted cyclists overnight and at weekends. When the footpath is closed the shuttle bus service will be available for people who need to make essential journeys either side of the bridge.

UPDATE (20th May 2020): Pedestrian & cyclist access under the railway bridge on Gipsy Patch Lane has been temporarily suspended during daytime working hours (8am to 4pm) for approximately the next two weeks (so most likely until week commencing 1st June 2020). The shuttle bus service has consequently been reintroduced during these hours.

UPDATE (9th April 2020): A narrow footpath, suitable for pedestrians and dismounted cyclists only, has been reopened under the railway bridge. Read more…

UPDATE (3rd April 2020): The bridge demolition/installation has been postponed due to the coronavirus crisis. Read more…

Photo of the Gipsy Patch Lane railway bridge (looking westwards).

More information and related related links:

* The SGC information page should be considered the definitive source of information about the CPME project and all associated roadworks

** The Travelwest page has been superseded by the SGC page, but is retained for archival purposes.

Advertisement

CPME Project contacts

Network Rail 24/7 helpline
Works around Gipsy Patch Lane Bridge
t: 03457 114141 (24hrs)

Alun Griffiths Contractors – Public Liaison Office
Works around Gipsy Patch Lane Bridge
t: 0330 0414635

CPME Project Team at South Gloucestershire Council
Enquiries about the wider CPME Project
t: 01454 868009

Source: Cribbs Patchway MetroBus Extension project contacts

Pedestrian & cyclist access temporarily suspended (20/05/20)

To enable Network Rail and Alun Griffiths to carry out preparatory and highways work the footpath under the bridge will be closed between 8am and 4pm Monday to Friday, for approximately two weeks (effective immediately). During this time a shuttle bus service will be available for people who need to make essential journeys either side of the bridge.

The shuttle bus pick up points will be Gifford Crescent and the turning circle near to Pegasus Park.

Shuttle bus timetable:

  • Gifford Crescent – 15 and 45 minutes past the hour
  • Turning circle near to Pegasus Park – on the hour and 30 minutes past the hour

The shuttle bus service is being operated by Stagecoach who have implemented a number of social distancing measures on their services.

The footpath under the railway bridge will only be open to pedestrians and dismounted cyclists overnight and at weekends during this period. Network Rail and Alun Griffiths continue to work on site.

Eight-month road closure to start 5th March

From a press release dated 18/02/20.

Photo of a dot matrix road sign informing of the closure of Gipsy Patch Lane for 8 months.

Gipsy Patch Lane will be closed to all road users at the railway bridge for approximately eight months from Thursday 5th March.

Access to properties along Gipsy Patch Lane will be maintained and all shops and businesses on and near Gipsy Patch Lane will be open as normal.

Network Rail and its contractor Alun Griffiths will be working towards re-opening a route for pedestrians and dismounted cyclists beneath the new bridge as soon as possible.

There will be a signed diversion route throughout the closure. This diversion route will take motorists via Bradley Stoke Way and the A38.

A number of pedestrian and cycling diversion routes will also be available (see below).

Map showing diversion routes for pedestrians and cyclists.

Image: Diversion routes for pedestrians and cyclists.

Diversion route option 1 – Filton Avenue
This route utilises the A38 and Filton Avenue and is especially suitable for cyclists who use the A4174 Ring Road cycle path.

Diversion route option 2 – Little Stoke Lane
This route utilises Little Stoke Lane and the A38 and is predominantly on road.

Diversion route option 3 – Little Stoke Park
Little Stoke Park can be accessed from Gipsy Patch Lane and contains shared use paths leading to a footbridge to the north of Patchway Station. A Public Right of Way can then be followed to the east of the railway to the A38.

Diversion route option 4 – For Patchway Railway Station
This route is for pedestrians and cyclists wanting to access Patchway Railway Station and businesses along Station Road.

Shuttle bus

During the closure of Gipsy Patch Lane, Network Rail will operate a shuttle bus for pedestrians needing access either side of the bridge.

This service will be free of charge and will operate for the duration of time the railway bridge is closed to pedestrians.

The pick-up/drop off points will be at the existing bus stop on Gifford Crescent, on the east of the bridge, and at the turning circle on Gipsy Patch Lane next to the entrance to Pegasus Park, on the west of the bridge.

The service will run every 30 minutes between 6am and 7pm and once an hour between 7pm and 6am.

Between 7pm and 6am when the shuttle bus is not in use it will wait on the east side of the bridge (Gifford Crescent). However, should a passenger need transport during this time from the west side of the bridge they should call the operator on 0117 965 0000 who will then advise the driver accordingly.

Above: Map showing location of shuttle bus stops and route. [View larger version]

Station Road junction closure

Station Road will also need to be closed to all vehicles at its junction with Gipsy Patch Lane from Thursday 5th March for approximately eight months.

A diversion route for vehicles, to reach Station Road via Clay Lane and Little Stoke Lane, will be in operation and will be fully signposted throughout the junction closure.

Pedestrians and cyclists will still be able to access Station Road via Gipsy Patch Lane during the closure.

All businesses on and near Station Road, including Patchway Railway Station and the Sort It Centre, will be open as normal.

Three-way lights at Gifford Crescent junction (issued 06/02/20)

BT will be carrying out further diversion work as part of the Gipsy Patch Lane railway bridge replacement on Sunday 9th February.

BT will be trenching and duct laying across Gifford Crescent at its junction with Gipsy Patch Lane. To enable this work three-way temporary traffic lights will be in use. The work is expected to take one day.

Dates and timeframes may be subject to further change.

Overnight closure of Gipsy Patch Lane (issued 23/01/20)

Gipsy Patch Lane will be closed at the railway bridge to all road users between 10pm on Thursday 23rd January and 2am on Friday 24th January (approximately four hours). Access will be maintained to Pegasus Park and Gifford Crescent. Station Road remains closed at its junction with Gipsy Patch Lane.

A two-way signed diversion route will be in place and will take motorists along Bradley Stoke Way and the A38. Network Rail and their contractors Alun Griffiths will provide an on demand shuttle service for any pedestrians or cyclists needing to travel under the railway bridge during this temporary closure.

Station Road junction closure (issued 07/01/20)

Photo of a road sign informing that Station Road will be closed for two weeks from Monday 13th January 2020.

The planned closure of the junction of Station Road with Gipsy Patch Lane has been postponed by the contractor and will now take effect from Monday 13th January 2020. The closure will last approximately two weeks.

A diversion route for vehicles, to reach Station Road via Clay Lane and Little Stoke Lane, will be in operation and will be fully signposted throughout the junction closure. Please be aware that access to businesses to the southern end of Station Road will involve travelling under a footbridge with a height restriction of 4.2 metres.

Pedestrians and cyclists will still be able to access Station Road via Gipsy Patch Lane during the closure.

All businesses on and near Station Road, including Patchway Station and the Sort It Centre, will be open as normal.

Station Road junction closure (issued 16/12/19)

To enable Network Rail and their contractors Alun Griffiths to continue with the piling work, the junction of Station Road with Gipsy Patch Lane will be closed to all vehicles for approximately two weeks from Monday 6th January 2020.

Weekend working (issued 11/12/19)

Work, including piling, will be taking place at the railway bridge on Gipsy Patch Lane this coming weekend, Saturday 14th December and Sunday 15th December, between the hours of 8am and 5pm, says South Gloucestershire Council.

These additional days are to enable Network Rail and their contractors Alun Griffiths to continue work on building the new railway bridge and its foundations.

Update on overnight piling work (issued 22/11/19)

South Gloucestershire Council has announced that overnight piling, originally due to start on 20th November, will now commence on Monday 2nd December.

This first phase of overnight piling work will last for four nights from Monday 2nd December to Thursday 5th December, between 6pm and 3am.

There will be up to 18 nights of piling work, but these will not run consecutively and will be carried out in phases.

A council spokesperson said:

“Noise and vibration will be monitored throughout the work and we will make adjustments if necessary. We are working with Network Rail and their contractors to minimise the disruption and have put in place a number of noise mitigation measures such as sound barriers around the piling equipment.”

“Should you have an urgent enquiry during any of the piling work please call the Network Rail 24-hour helpline number on 03457 114141.”

Overnight piling to start 20th November 2019

South Gloucestershire Council has announced that the first phase of overnight piling work at the Gipsy Patch Lane railway bridge site is due to take place for three nights from Wednesday 20th November to Friday 22nd November, between 6pm and 3am, and on Monday 25th November, between 6pm and 3am.

Piling work starting mid-October 2019

The new railway bridge on Gipsy Patch Lane will weigh approximately 4,500 tonnes with pile foundations to a depth of 25 metres.

Piling is required at the four corners of the new railway bridge.

This project will use two types of piling techniques. Both of these are noisy, however the contractors say they will work to minimise the disturbance and will put in place a number of noise mitigation measures such as sound barriers around the piling equipment and working at daytime wherever possible.

The piling work is due to start the week commencing Monday 14th October and will be carried out over a period of approximately three months. The majority of the piling will take place during the daytime between the hours of 7.30am and 6pm, Monday to Friday. It is not expected that piling will be carried out every day during this time.

Due to the sensitive nature of the work carried out by businesses close to the railway bridge, some of the piling will have to be done overnight or during weekends. It is expected that overnight work will be required from mid-October to early-December for approximately 18 nights. Overnight work will be carried out between the hours of 6pm and 3am.

If weekend work is required this will only take place on Saturday mornings between 8am and 1pm.

Traffic management starting September 2019

Photo of a 'Work starting here soon' sign at the railway bridge.

To assist the preparation works a number of traffic management measures will be in use over the coming months.

From Monday 2nd September temporary three-way traffic lights will be in operation on Gipsy Patch Lane at the railway bridge. These will be in place for up to two weeks.

After this period automated Stop/Go boards will be used as needed on Gipsy Patch Lane. These will only be used when workers and machinery from the construction site need to safely cross Gipsy Patch Lane, their use will be kept to a minimum and as far as possible will be kept to off-peak times.

All shops and businesses on and near Gipsy Patch Lane will be open as normal.

Update issued 13th September 2019

The three-way temporary traffic lights at the railway bridge on Gipsy Patch Lane are to remain in place for at least a further week. Contractors are currently installing crossings on Gipsy Patch Lane as part of preparation works for the bridge replacement next year. The extension to the temporary lights is needed to enable additional work to lower a utility cable.

Safety is paramount and given the limited space around the railway bridge the temporary lights help protect workers and members of the public whilst this work is completed.

This additional work will not affect the project’s timetable.

The temporary lights will only operate Monday to Friday during off-peak hours and pedestrians and cyclists will continue to be able to pass under the railway bridge. Cyclists may be asked to dismount.

June 2019 closure

Photo of a matrix sign displaying a message about the planned closure of Gipsy Patch Lane for four weeks in June 2019.

Roadworks are currently taking place on Gipsy Patch Lane in preparation for the man construction work, which is expected to start later this year. The current work is being undertaken by BT to divert underground utilities.

The next phase of BT’s preparatory work will require Gipsy Patch Lane to be closed to all vehicles at the railway bridge for approximately four weeks during June. A route under the bridge will be maintained for pedestrians and dismounted cyclists during the closure.*

A signed diversion route will be in place during this time.  Access to properties and side roads along Gipsy Patch Lane will be maintained and no disruption to the supply of utilities is expected. Businesses and shops along and near Gipsy Patch Lane will be open as normal.

Dates of the full closure and diversion routes will be clearly signposted.

* The council previously stated that the road would be “closed to all highway users, including pedestrians and cyclists”.

Major traffic congestion reports on Facebook

See also: Post-event feedback on the four-week closure (BSJ Facebook)

Update (24th May 2019): Start date of Monday 3rd June confirmed

A South Gloucestershire Council spokesperson said: “BT’s works are on track for the road closure to begin on Monday 3rd June. Advance warning signs featuring the start date were placed at appropriate locations on the local road network on 20th and 21st May.”

Update (27th June 2019): Reopening date confirmed as Monday 1st July

A South Gloucestershire Council spokesperson said: “We are pleased to confirm that Gipsy Patch Lane will reopen as planned before the morning peak period on Monday 1st July. Although [BT] Openreach has completed a lot of the planned work, unfortunately, due to unexpected ground conditions and locations of other live utility pipes and cables, Openreach has not completed it all. The remaining work to lower some of the ducts and cables will now be carried out during the main Cribbs Patchway MetroBus Extension construction programme in 2020. This will avoid the need to extend the current closure beyond 1st July.”

“We would like to thank residents, businesses and all road users for their patience during this time and apologise for the inconvenience caused.”

Update (28th June 2019): Road reopened at around 5pm

A reader reported at 5pm that Gipsy Patch Lane had been reopened at the railway bridge.

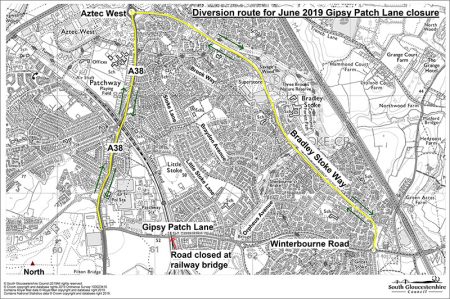

Gipsy Patch Lane signed diversion route June 2019.

Above: Diversion route for the June 2019 closure [click to enlarge].

Site compound near the railway bridge

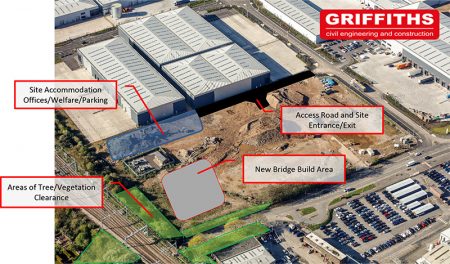

Plan of the Alun Griffiths site compound at Gipsy Patch Lane.

Above: Overview of the site compound area that is currently (August 2019) being set out on part of the Horizon 38 development. The railway bridge is in the lower left corner of the image. Source: Presentation made by Griffiths in July 2019.

Public drop-in information sessions

January 2020

To help keep you informed and to explain more about CPME and other highway improvement works taking place in the area this year, South Gloucestershire Council is holding a series of public drop-in events:

  • Wednesday 22nd January, 4pm to 7pm, at Little Stoke Primary School, Little Stoke Lane, Little Stoke BS34 6HY
  • Saturday 25th January, 11.30am to 2.30pm, at Little Stoke Community Hall, Little Stoke Lane, Little Stoke BS34 6HR
  • Monday 27th January, 4pm to 7pm, at the St Michael’s Centre, North Road, Stoke Gifford BS34 8PD
  • Thursday 30th January, 4pm to 7pm, at Baileys Court Activity Centre, Baileys Court Road, Bradley Stoke BS32 8BH

Officers from the council will be available to answer your questions, along with representatives from Network Rail and Alun Griffiths who are involved with the CPME project. Everyone is welcome to attend, there is no need to book. Please note these are drop-in sessions and you can attend at any time during the session.

On Saturday 25th January members of the TravelWest team will also be on hand at the Little Stoke Community Hall event offering advice on alternative, active and sustainable travel options. They will also be able to help with journey planning.

October 2019

South Gloucestershire Council is hosting a drop-in session at Little Stoke Primary School, Little Stoke Lane, Little Stoke, on Tuesday 8th October between 4pm and 7pm for people who have any questions regarding the upcoming piling work (see above). At the event members of the project team, including representatives from Network Rail and Alun Griffiths (Contractors), will be available to speak to.

May 2019

To help keep you informed and to explain more about the CPME works, South Gloucestershire Council is holding a series of public drop-in events during May 2019:

  • Wednesday 8th May, 5pm-7pm, at Little Stoke Primary School, Little Stoke BS34 6HY
  • Monday 13th May, 3pm-6pm, at Patchway Community Centre, Rodway Road, Patchway BS34 5PF
  • Tuesday 14th May, 3pm-5pm, at Baileys Court Activity Centre, Baileys Court Road, Bradley Stoke BS32 8BH
  • Monday 20th May, 3.30pm-6.30pm, at Little Stoke Community Hall, Little Stoke Lane, Little Stoke BS34 6HR
  • Tuesday 21st May, 4pm-7pm, at The St Michael’s Centre, The Green, Stoke Gifford BS34 8PD
  • Wednesday 22nd May, 3pm-6pm, at BAWA Centre, 589 Southmead Rd BS34 7RG

Overview of main work on Gipsy Patch Lane

From documents published as part of the planning application.

Gipsy Patch Lane road closures for construction of the CPME scheme.

Click the above image to enlarge it in a pop-up window.

Outline programme schedule

Gantt chart showing the CPME construction programme.

Above: CPME construction programme (as of Oct 2019). [Click to enlarge]

Complete

  • Spring 2014 – Site surveys and preliminary design work
  • Autumn/winter 2015 – Public consultation
  • Winter/spring 2016 – Consultation analysis
  • Summer 2016 to Summer 2017 – Detailed design
  • February 2018 – Planning applications submitted
  • July 2018 – Planning applications approved
  • February 2019 – Utility works on Gipsy Patch Lane
  • June 2019 – Four week closure of Gipsy Patch Lane for utility diversions
  • June 2019 – the West of England Combined Authority (WECA) and the West of England Joint Committee approved more than £56m investment for the Cribbs Patchway metrobus extension

To be completed

  • Summer 2019 – Preliminary works start on Gipsy Patch Lane
  • Spring 2020 – Gipsy Patch Lane closure for bridge construction (approximately 8 months)
  • Autumn 2020 – Works on Gipsy Patch Lane (east of the bridge)
  • Winter 2020 – Gipsy Patch Lane reopens
  • Early 2021 – Works on Gipsy Patch Lane (west of the bridge)
  • 2022 – Construction complete

The full business case approved by the West of England Combined Authority on 14th June 2019 states:

“Construction start is planned in July 2019 with completion expected in April 2022.”

A log of how the above dates have changed with time may be viewed on the Journal’s main CPME webpage.

Gipsy Patch Lane railway bridge replacement video

Video of the Gipsy Patch Lane railway bridge replacement - by Alun Griffiths (Contractors) Ltd.

Video by Network Rail’s bridge work sub-contractors Alun Grifiths (Contractors) Ltd showing how the replacement railway bridge will be constructed and moved into position: Gipsy Patch Lane Bridge Replacement

Similar project previously carried out by Griffiths: Battenhall Bridge timelapse video

Railway closure

The currently planned date for the closure of the railway, to allow the existing bridge to be demolished and the new bridge installed is:

Saturday 11th April 2020 to Sunday 19th April 2020

Trains between London Paddington and South Wales will be diverted between Swindon and Newport, extending normal journey times by around 45 minutes.

Trains between Taunton and Cardiff Central will terminate at Bristol Temple Meads.

Trains between Portsmouth Harbour and Cardiff Central will terminate at Bristol Parkway instead.

Buses will replace trains between Bristol Parkway and Newport.

Train services will also be affected on the following weekends:

  • Saturday 25th and Sunday 26th April
    Saturday 2nd and Sunday 3rd May

Source: Planned engineering (GWR)

Photos

Gipsy Patch Lane Railway Bridge work collage.

Click the above image to visit the Stoke Gifford Journal’s Gipsy Patch Lane Railway Bridge Replacement album on Google Photos, which contains scores of images covering the duration of the project to date.

See also:

  • 2019-06-24 Gipsy Patch Lane Roadworks (on Facebook)
  • 2019-06-13 Gipsy Patch Lane Roadworks (on Facebook)

Time lapse videos

Time lapse videos recorded by Alun Griffiths (Contractors):

Gipsy Patch Lane travel survey

South Gloucestershire Council (SGC) is currently considering options to manage traffic during the main Cribbs Patchway MetroBus Extension construction work on Gipsy Patch Lane which is due to start later in 2019.  To this end, it is conducting an online travel survey to better understand travel patterns on Gipsy Patch Lane.

The council is asking everyone who travels along this road regularly to complete the survey. It should take about five minutes to complete.

The survey can be found at www.southglos.gov.uk/GPLsurvey and it is open until Wednesday 20th March 2019.

Progress reports

Updates on the SGC Cribbs Patchway metrobus extension – CPME Facebook page:

Log of changes made to SGC’s CPME information page

16th June 2020
Announcement that “following feedback from members of the public” changes have been made to the footpath under the railway bridge “to encourage cyclists to dismount and to deter them from cycling through”. New staggered barriers and additional signs have been put up at the points at which the footpath narrows.

16th December 2019
Announcement that the junction of Station Road with Gipsy Patch Lane will be closed to all vehicles for approximately two weeks from Monday 6th January, to enable Network Rail and their contractors Alun Griffiths to continue with the piling work.

11th December 2019
Announcement that work, including piling, will be taking place at the railway bridge on Gipsy Patch Lane on Saturday 14th December and Sunday 15th December, between the hours of 8am and 5pm.

26th November 2019
Announcement that the start of overnight piling at the railway bridge has been delayed to Monday 2nd December. (It was originally due to start on 20th November.)

24th October 2019
Gantt chart image ‘CPME construction programme October 2019’ added to project timetable section. Entry ‘Autumn 2020 Works on Gipsy Patch Lane (east of the bridge)’ added to project timetable section.

11th October 2019
Announcement that three-way traffic lights will be in place at the railway bridge for up to two weeks from Monday 14th October in order to allow Wales & West Utilities to divert a gas main.

10th October 2019
Network Rail helpline telephone number added – for use during piling works.

30th September 2019
Announcement that piling work at the railway bridge site is due to start week commencing Monday 14th October. It will be carried out over a period of approximately three months. During the piling work, automated stop/go boards will be used as needed on Gipsy Patch Lane, but only when workers and machinery need to safely cross the road. A drop-in information session has been arranged for Tuesday 8th October.

23rd September
Announcement that the temporary traffic lights at the railway bridge “have now been removed”, adding that: “Work will continue in the area in preparation for the railway bridge replacement next year and this will include the occasional use of Stop/Go signs.”

13th September 2019
Announcement that the three-way traffic light at the railway bridge will “remain in place for at least a further week”.  Reason given: “To enable additional work to lower a utility cable.”

27th August 2019
Announcement that three-way traffic lights will be in operation at the railway bridge “for up to two weeks” from Monday 2nd September.

15th August 2019
Webpage restyled. Information about traffic management in September 2019 added.

27th June 2019
Addition of statement that Gipsy Patch Lane will “reopen as planned before the morning peak period on Monday 1st July”.

29th May 2019
Specific start date of Monday 3rd June reinstated for June full closure.

20th May 2019
Link to a video about the replacement of the railway bridge added (as played at the drop-in sessions during May 2019).

9th May 2019
In relation to the June 2019 road closure: “Gipsy Patch Lane [will be] closed to all highway users, including pedestrians and cyclists, at the railway bridge” changed to “A route under the bridge will be maintained for pedestrians and dismounted cyclists during the closure”.

23rd April 2019
Addition of “businesses will be open” as usual to June 2019 section.
Specific start date for June full closure of Monday 3rd June deleted.

22nd April 2019
Details of public drop-in information sessions during May added.

25th March 2019
Details of Gipsy Patch Lane travel survey (closed on 20th March) deleted.

Project newsletters

Archive of e-newsletters published by SGC:

19th February 2020
Gipsy Patch Lane closure

10th January 2020
Public drop-in events

6th November 2019
Update on overnight piling work on Gipsy Patch Lane

11th October 2019
Cribbs Patchway metrobus extension – Traffic management update

30th September 2019
Cribbs Patchway metrobus extension – Piling works

13th September 2019
Cribbs Patchway metrobus extension – Traffic management update

16th August 2019
Cribbs Patchway metrobus extension update – Gipsy Patch Lane preparation works

29th May 2019
Gipsy Patch Lane to close for 4 weeks on Monday 3 June

18th April 2019
Roadworks on Gipsy Patch Lane and public drop-in events

Sign up here to receive e-newsletters.

Recent MetroBus Extension build stories in the Journal

MetroBus Extension Build stories in other media

MetroBus work ‘will cost our jobs’ warn businesses hit by road closures
10th July 2019 | Bristol Post
Work to install a new MetroBus route across north Bristol looks set to cost people their jobs because of the roadworks affecting business…

Gipsy Patch Lane closure led to 40% drop for tyre business
9th July 2019 | BBC Bristol
A business next to a road that was closed to start work for a MetroBus extension said takings dropped 40% during the work…

Share this page:
